Pukekohe North Wastewater Upgrades
We’re building a new wastewater pump station and installing 4km of pipeline to support growth in your community.
Duration
March 2026 – Early 2028
Location
Pukekohe North
Status
Construction
Project overview
Pukekohe is a growing community, with approximately 50,000 people expected to move into the area over the next 20 years. To support the existing and upcoming growth in Pukekohe North and the Paerata catchment areas, we’re building a new wastewater pump station and installing 4km of pipeline to increase capacity and improve network resilience. The project will also help to protect the environment by reducing the risk of wet weather overflows.
Pukekohe North Wastewater Pump Station

Artist impression of the new pump station
We’re building a new 480l/s (litres per second) transmission wastewater pump station at 50A Isabella Drive, Pukekohe.
Once complete, it will divert the wastewater flows from the existing Cape Hill and Isabella wastewater pump stations (WWPS), allowing us to decommission the aging infrastructure. It will also divert some of the wastewater flows from the Franklin Road WWPS, which will reduce the capacity issues it is currently experiencing.
For the duration of the project, our construction laydown area will be located next to this site at 50 Isabella Drive, Pukekohe.
Pukekohe North Wastewater Pipeline

Click here to view full size map
To connect the new WWPS into the existing network, and divert the wastewater flows from the existing pump stations, we are installing 4km of new pipeline that will run along:
- Isabella Drive
- Franklin Road
- Stadium Drive
- Station Road, and
- Manukau Road.
This pipeline will be installed using a combination of open trenching and a trenchless method called Horizontal Directional Drilling (HDD). Wherever possible, our team will use HDD to reduce the impact to the community.
Current Activity
We are making good progress across the project’s alignment, and we remain very grateful for the support and understanding of the Pukekohe community.
The works mean inevitably there will be disruption to road users, and to ensure people can travel safely we request that drivers:
- Follow all signage
- Treat the temporary traffic lights as you would regular traffic signals
- Take extra care because the road layout will be changed.
Our general working hours are Monday to Saturday, 7am-6pm. During working hours, general construction noise, vibrations, and increased vehicle movements should be expected. We will ensure our work is kept within our consented limits.
Should we have to work night shift, the working hours are Sunday to Friday, 7pm – 5am.
The team are working across the alignment, but in particular Isabella Drive, Franklin Road and Station Road are where we are busiest.
Isabella Drive
We are making good progress with the work in this area and are now preparing to commence installation of the next section of pipeline through the Isabella Drive/ Cape Hill Road intersection.
This work involves establishing a temporary stop/go traffic light system from Wednesday 25 November until Wednesday 31 December.
During this work, an approved traffic management plan (TMP) will be in place. Our traffic controllers will be located along the road to help you during working hours. You will notice changes such as:
- No right turn onto Isabella Dr from Cape Hill Rd
- No left turn onto Cape Hill Rd from Isabella Dr
- Reduced on-street parking
- Reduced speeds
- Diversions in place.
If you live along a closed section of road please put your rubbish bins out as usual. Our team will ensure they are collected are returned on collection day. The below diagram shows the locations of the lights, work spaces and closed lanes.

The above map shows the location of the work areas, closures and light controls. Click here to view the map full size.
Franklin Road
This work was previously notified to start on Monday 23rd. It will start on Monday 30th.
As the work progresses south along Franklin Road the construction of the pipeline will start to move across from the northbound lane into the southbound lane.
The current one-way detour will remain in place until 31 March 2027. Vehicles will be able to enter via the Cape Hill Roundabout and exit at Stadium Drive.
Within this one-way detour we will also be implementing a temporary stop/go traffic light system.
This will be in place from Monday 30 November (previously 23 November) until the end of February 2027. This allows us to keep access open for the businesses on the northbound lane side.
Please note that there will be no through traffic to Cape Hill Road from the northbound lane.

In the image above the yellow line represents the new area of works, and please note these works will not stop access to businesses on either side of the road, including the Navigation Homes Stadium. Because of the team’s methodology there is no need to dig trenches across the stadium’s driveway, enabling that access to continue.
Stadium Drive
We will soon be starting construction work in Stadium Drive also so please look out for updates.
Station Road

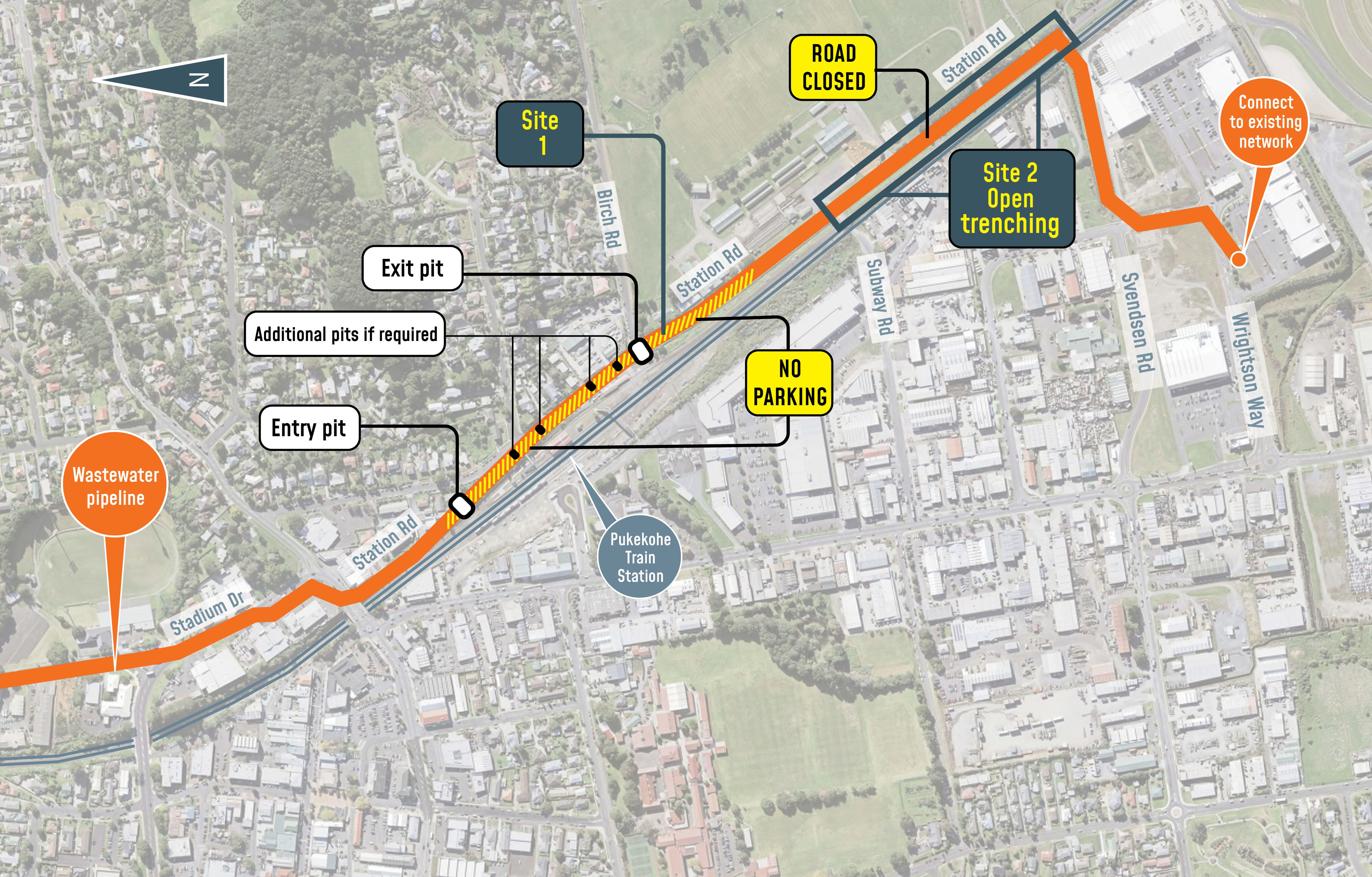

There are still ongoing works between Birch Road and Subway Road in Station Road as the team continue their work. It is due for completion in December 2026. There will be further south of Subway Road after that as the team work to install the pipeline across the railway line and into the retail park around Wrightson Way and Svendsen Road.
There will be further updates closer to the time.
How will these works affect you?
Our general working hours are Monday to Saturday, 7am-6pm. During working hours, general construction noise, vibrations, and increased construction vehicle movements should be expected. We will ensure our work is kept within our consented limits.
From time to time, night works may also be required. If this happens, affected residents will be advised in advance.
During this work, an approved traffic management plan (TMP) will be in place. Our traffic controllers will be located along the road to help you during working hours. You will notice changes such as:
- Stop/go traffic management
- Partial road closure on Station Road
- Road diversions
- Reduced parking
- Reduced speeds
To keep everyone safe, please follow all signs, light signals, and traffic directions.
During open trenching, access to private property may be temporarily impacted. Our contractors will speak to impacted residents ahead of time.
